Steep slip-damaged slope in the Waioweka Gorge near Opotiki

Difficult Access / Slope Stabilisation

Opotiki Slope Anchor Installation

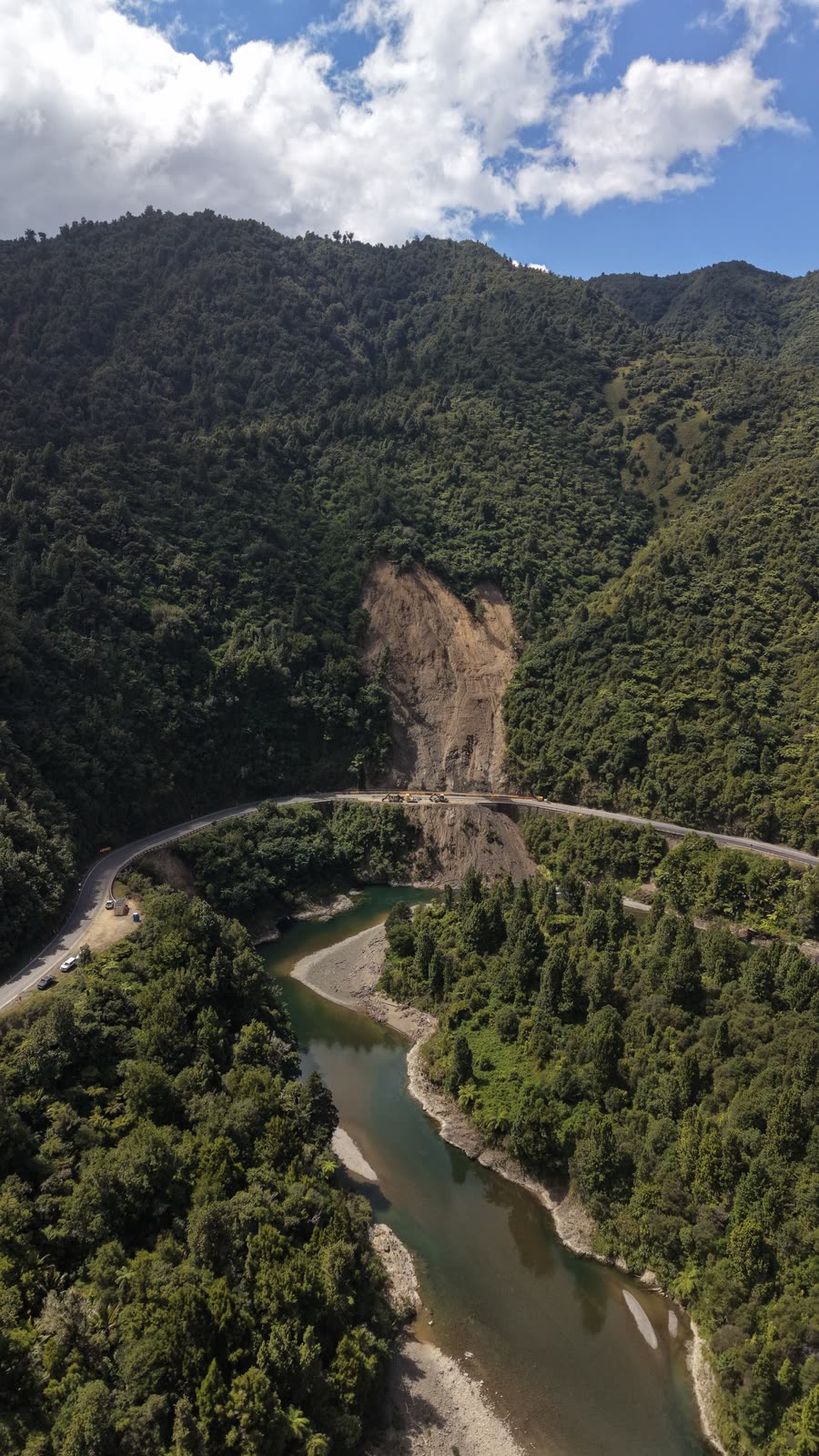

A slip-damaged slope in the Waioweka Gorge near Opotiki had no road access — the work face sat at roughly 140m elevation, reached by a 180m climb through bush and a 40m abseil. Our four-person rope access crew flew in heavy gear by helicopter, then drilled, grouted, and shear-loaded eight soil nail anchors in two clusters, giving Tough Terrain's spider excavator the winch points it needed to descale the slope. Delivered in two weeks under an NZTA contract.

Opotiki, Bay of PlentyField record 04

The challenge

What made this difficult

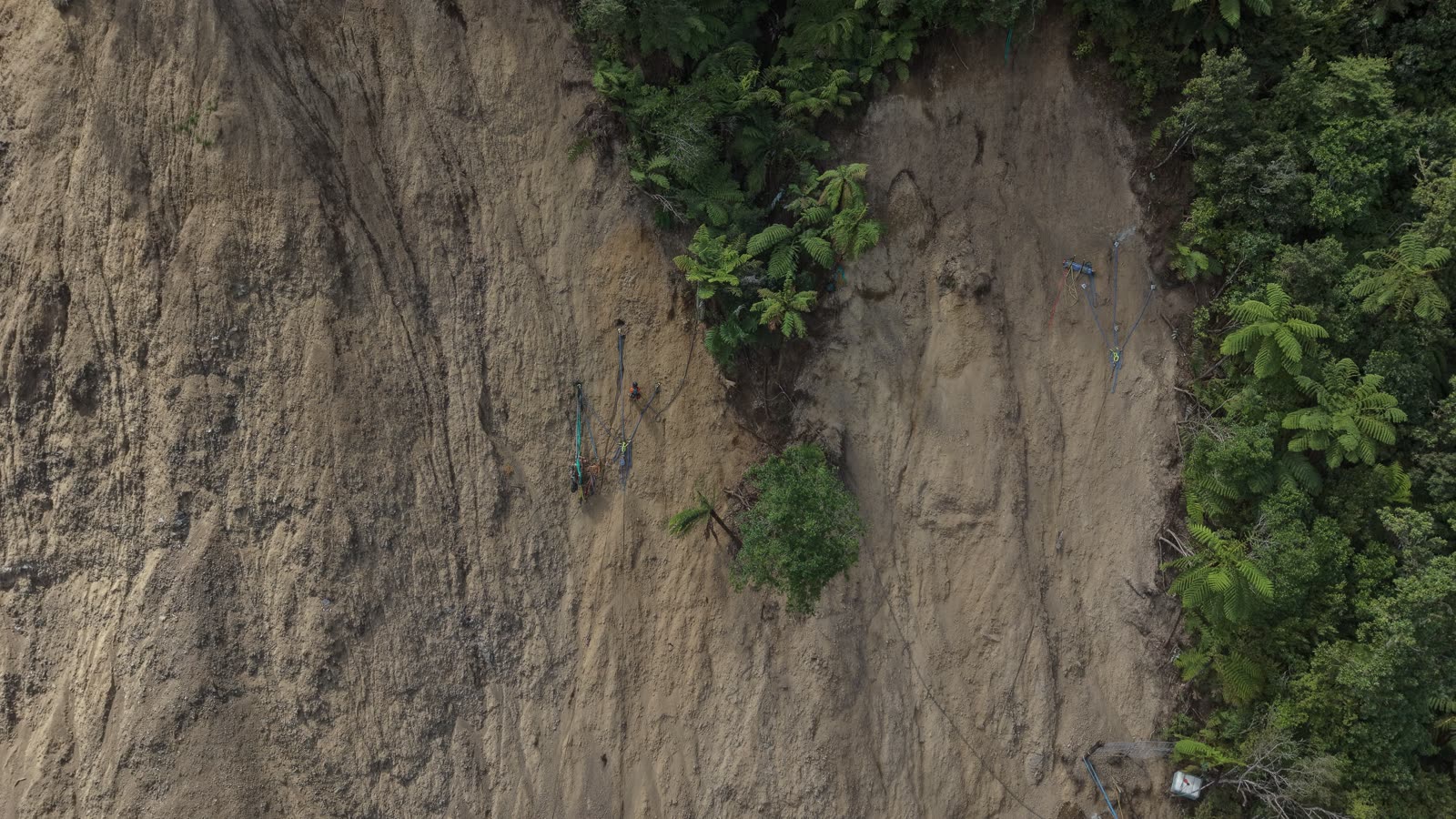

A slip-damaged slope in the Waioweka Gorge near Opotiki needed descaling by spider excavator, but the machine had no way to climb the face without anchor points to winch from. The site had no formed road access, with the work face sitting at around 140 metres elevation. The only way in was a 180-metre climb on foot through steep bush, then abseiling down from the ridge to the installation zone.

Specific issues

  • No formed access to the slope face, requiring a 180-metre approach on foot through steep bush

  • Heavy equipment (compressors, grout bowls, drilling rigs) too large to carry, requiring helicopter lifts

  • Work face at approximately 140m elevation, accessed by abseiling from the ridge above

  • Anchors needed to be shear-loaded to support spider excavator winching operations

The response

  1. 01

    Carried all rope access gear 180m up through steep bush terrain on foot to set ropes at the ridge

  2. 02

    Set up pulley rope systems to transport heavy equipment up and down the slope

  3. 03

    Coordinated helicopter lifts for compressors, grout bowls, and drilling equipment

  4. 04

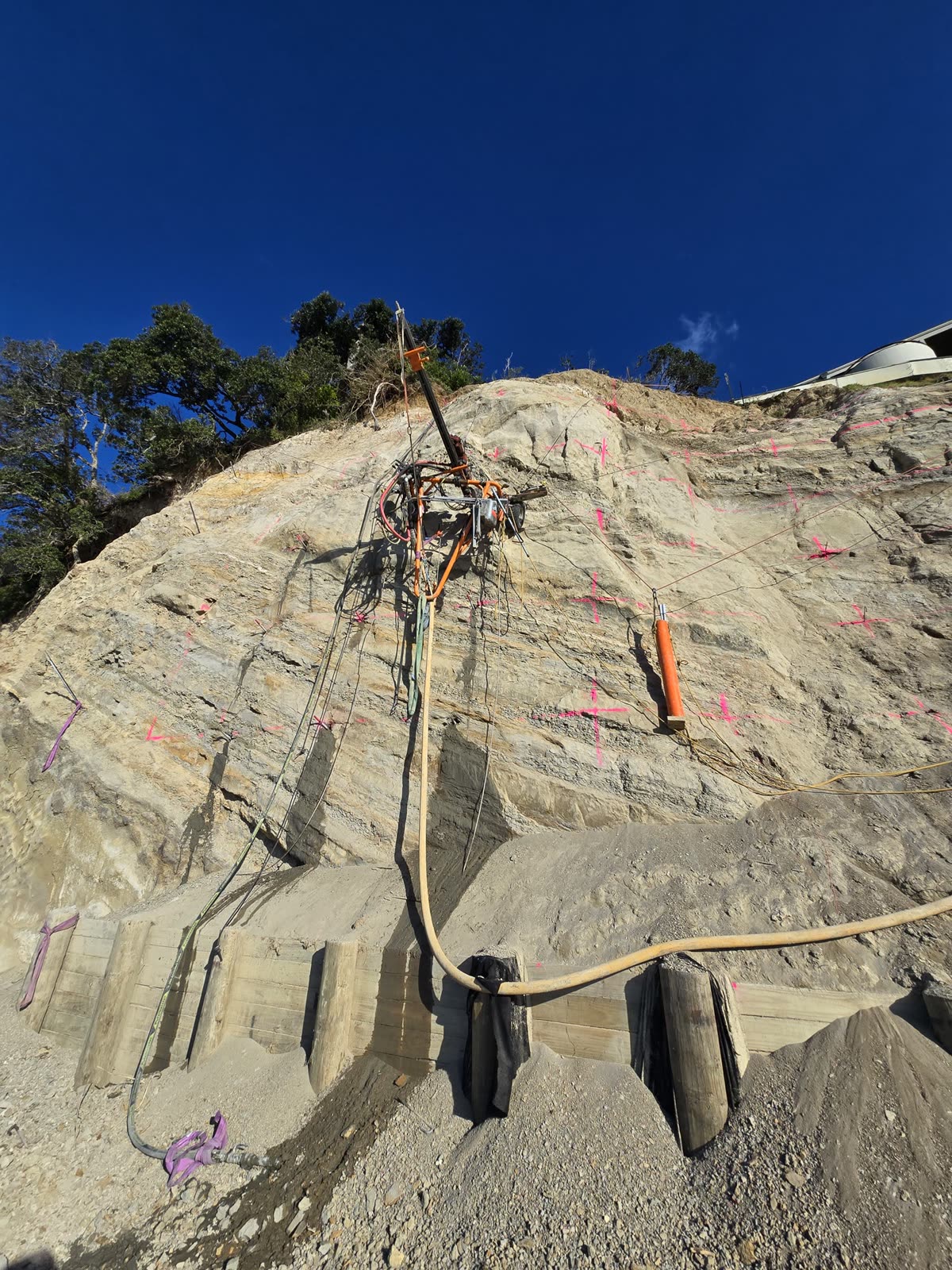

    Abseiled approximately 40m from the ridge to the work face and drilled two clusters of four soil nail anchors into the cliff

  5. 05

    Grouted and shear-loaded each cluster to serve as winch points for Tough Terrain's spider excavator

  6. 06

    Four-person rope access crew worked through weekends over a two-week programme

  7. 07

    Fully demobilised all equipment back down the slope on completion

Spec snapshot

The numbers on record

  • 018 soil nail anchors installed in two clusters of four, drilled in a cross position
  • 02All anchors grouted and shear-load verified as winch points
  • 03Approx. 40m abseil from ridge to work face; work face at ~140m elevation
  • 04Two-week programme including weekend work by a four-person rope access crew
  • 05Helicopter lifts for compressors, grout bowls, and drilling equipment

The outcome

Work that holds up.

All eight anchors were installed, grouted, and verified for shear loading within two weeks. The anchor clusters gave Tough Terrain's spider excavator the hold it needed to climb the slope and carry out descaling works safely. Delivered under an NZTA contract through Tough Terrain. Everything was walked in, winched, or flown in by helicopter — and everything was demobilised off the slope on completion. It is the kind of difficult-access work Geo Mana was built for.

  • Abseil drilling
  • Soil nail installation
  • Grouting
  • Helicopter logistics
  • Rope access
  • Pulley rope transport systems
  • Shear load anchoring
